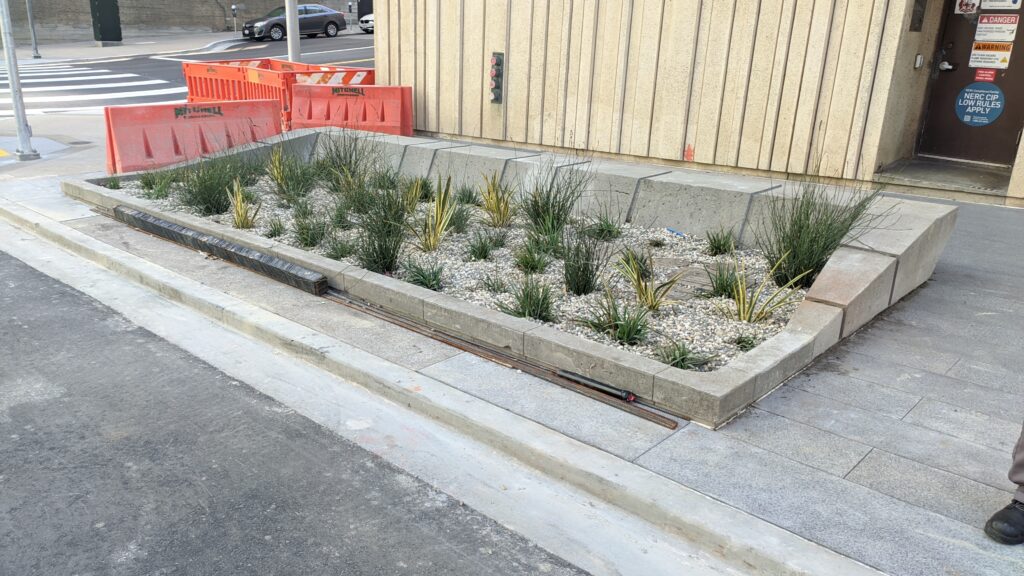

Posted on March 3, 2021
Construction Update for 3/1/20:
The Folsom Streetscape Improvement Project reached Substantial Completion (all contract work completed, short of punch list items) on February 19, 2021. The punch list items left to complete include:
Thanks to all residents, businesses, and visitors for your patience during this extended construction process. The East Cut CBD is confident that this new, multi-modal, pedestrian-oriented thoroughfare will be fully realized as a hub of social and economic activity in the neighborhood!
_________________________________________________________________________
Construction Update for 12/11/20:
For more information, click here to visit SF Public Works’ project website.
Work Recently Completed:
Ongoing Work:
Upcoming Work:
_________________________________________________________________________
Repaving Update for 11/02/20:
Good news, East Cut Residents & Business Owners: The contractor for the Folsom Streetscape Improvements Project completed scheduled roadway grinding and repaving at 2nd & Folsom this past weekend, and found efficiencies in their process. They are now projecting a 5-day reduction in the overall schedule, and should have the full extent of Folsom Street from 2nd to Spear streets fully repaved by the end of next week!
Additionally, the landscape contractor will be returning to Folsom and Fremont street intersection this week to finalize the rain garden work, and will be finishing the tree basin paving work as soon as possible. Bookmark this page for any additional updates.
_________________________________________________________________________
Dear East Cut Residents & Businesses,
Here is the latest Folsom Streetscape Improvements Project update from San Francisco Public Works. Please contact us at info@theeastcut.org if you have any questions or need additional information.
Construction Update for 10/26/20:
Currently, the contractor plans to start final road repaving work this Saturday, 10/31/20. The work will begin at the 2nd and Folsom streets intersection and will progress toward Embarcadero. The specific details may change, but the current overall plan can be viewed at the top of this story.
Barring any unforeseen issues, the road repaving along the entire corridor should be finished before the Thanksgiving holiday week.
Other work items include the Beale Street casual carpool sidewalk restoration, which is currently in progress, as well as tree basin restoration. The final paving material for the tree basins will be delivered and installed in approximately 3-4 weeks which is one of the final items. The grand opening for the project is near!
_________________________________________________________________________
Construction Update for 10/8/20:
Current Work:
· The new street trees were delivered on Monday and are currently being installed.
· At Fremont St: crews will continue work on the rain garden structure at the SW corner now that a utility conflict has been resolved. Remaining sidewalk work will be scheduled once the structure is complete.
· At Beale St and at Spear St: crews will begin installation of irrigation, soil, and planting in the completed rain garden structures.
· At Beale St: crews will start minor sidewalk work on the west side of Beale St to restore the casual carpool pickup/drop-off area.
Work to Be Scheduled Soon:
· The Contractor has secured approval on all traffic control plans for final asphalt paving and is working to schedule crews and SFMTA parking/traffic control officers in the next couple of weeks. While most paving will occur during the week, some intersection paving will be required to completed on Saturdays to mitigate traffic issues.
· Final miscellaneous landscape work and street furniture installation.
Special Notes and Delays:
· Due to COVID related manufacture delays, traffic signal and pole delivery was delayed from its original date. We have been informed that the anticipated delivery date is now late-November. Once delivered, crews will start work immediately to install the new poles and signals at each intersection. Coordination with PG&E is ongoing and the contractor will schedule final traffic signal switchovers as soon as it is possible.
_________________________________________________________________________
Construction Update for 8/27/20:
Ongoing Work –
Upcoming Work –
Special Notes and Delays –
_________________________________________________________________________
August 19, 2020
Dear East Cut Residents & Businesses,
The Folsom Streetscape Improvements Project is closing in on finishing, and we’ve received the following updates from San Francisco Public Works. Please contact us at info@theeastcut.org if you have any questions or need additional information.
Construction Update for 8/19/20:
Ongoing work –
• Crews are focused on finishing up the rain gardens at the corners of Fremont, Beale, and Spear.
• Minor electrical work continues as crews prepare to switch over traffic signals in September.
• Casual Carpool work on Beale St is slated to begin this week (traffic control plan approved 8/17/20)
• Crews have put down temporary paving at select locations
• Over the past few weeks, the Contractor has continued to work with SFMTA to review and approve its final asphalt paving and traffic control plans.
Upcoming work –
• Once SFMTA approves the Contractor’s final asphalt paving and traffic control plans, the paving crew will be scheduled to start within a couple weeks.
• Final asphalt paving, final traffic signal switchover, and final landscaping (pavers, trees, etc) is currently anticipated to occur in September.
Special Notes and Delays –
• Due to COVID-related manufacturing delays, traffic signal and street light pole delivery was delayed from its original date. We anticipate delivery to be completed in September.
• Due to the complexity of traffic control plan review and approvals, final asphalt paving has continued to be rescheduled. Work is anticipated to be completed in September.
Project Status per Scope –
• Sewer: 100% complete
• Water (potable): 100% complete
• AWSS (high-pressure water): 100% complete
• Traffic Signals: ~85% complete
• Pedestrian and Street Lights: ~95% complete
• Sidewalk and Curb Ramps: ~80% complete
• Bus Islands: 100% complete
• Landscape (trees, pavers, rain gardens, etc): ~80% complete
• Roadway (concrete base and final asphalt paving): ~70% complete
______________________________________________________________________________
July 24, 2019 Dear Neighbors, Below you will find a description of the work being performed for the next couple of weeks as part of theTransbay Folsom Streetscape Improvements Project. Please note that tree removals work has been temporarily delayed. We will keep you updated soon. 3 Week Look-Ahead Schedule 7/23-8/9/19 (West to East) Block 1 – (2nd Street – Essex Street) – Reconstruction of the new boarding island and reconstruction of the boarding aisle. 7/29/-8/1/2019 – Roadway – Roadway Block 2 – (Essex Street – 1st Street) – Install streetlight underground utilitiesDemo install – Roadway street base- replacement and renovations, both east and westbound sides. Block 3 – (1st Street – Fremont Street) – Curb and catch-basin (gutters) demolition and replacement (southside) – Roadway street-base replacement and renovations, both east and westbound sides. – Underground street-light installation Block 4 – (Fremont Street – Beale Street) – no activity Block 5 – (Beale – Main Street) – no activity Block 6 – (Main – Spear Street) – no activity The full scope of work at this location is: Tree removals (they will be replaced at the end of the project), demolition of the street-base and reconstruction of the bus-island, installation of street-light and traffic-signal underground poles and wires, sidewalk and curb-ramp reconstruction. Mitchell will also be working on sidewalk, curb, and street base demo on the Southside starting at 2nd going East. This will be concurrent with the bus island construction. For the sidewalk on the south side, they will keep the existing sidewalk along the building face for the path of travel while working on the sidewalk portion closest to the curb. Their electrical sub, Bay Area Light Works will follow behind with installed conduits/poles, and Bauman Landscaping will follow with curb and gutter pours. During Construction Your utility services will not be interrupted. Please continue to use your household and business plumbing as usual. Street parking may be impacted while construction occurs on a block. In some cases, depending on the phase of work, street parking may not be possible on part of the adjacent block as we taper traffic lanes in order to accommodate the necessary work zone. Crews also may detour traffic during sewer activity to allow for a safe work zone. We kindly ask that motorists please plan ahead and allow more travel time during construction hours. Please see the posted “no parking” barricade signs for exact work hours, days, and locations. Parking restrictions may vary per block depending on the scope of work. We apologize for the inconvenience and thank you for your patience as we make these critical improvements along Folsom Street. |
Project Updates Please visit for additional information. http://sfpublicworks.org/project/transbay-folsom-streetscape-improvement-project |
